On August 11, 2026, the D area of Zhongwei Xuanhe Computing Power Park in Ningxia reached a critical milestone. China Mobile (Ningxia Zhongwei) data center Xuanhe Park D area major civil engineering EPC project has completed all the bidding evaluation work, and three high-quality construction enterprises have been shortlisted as bid winning candidates. The large computing power park infrastructure project worth nearly 315 million yuan is about to land. On the northwest Gobi Desert, this national level green computing power new city is accelerating its formation. Ningxia Zhongwei, with its low-temperature climate, abundant wind and solar power, and abundant land resources, continues to undertake the massive storage, offline computing power, and disaster recovery business spillover needs in the east.

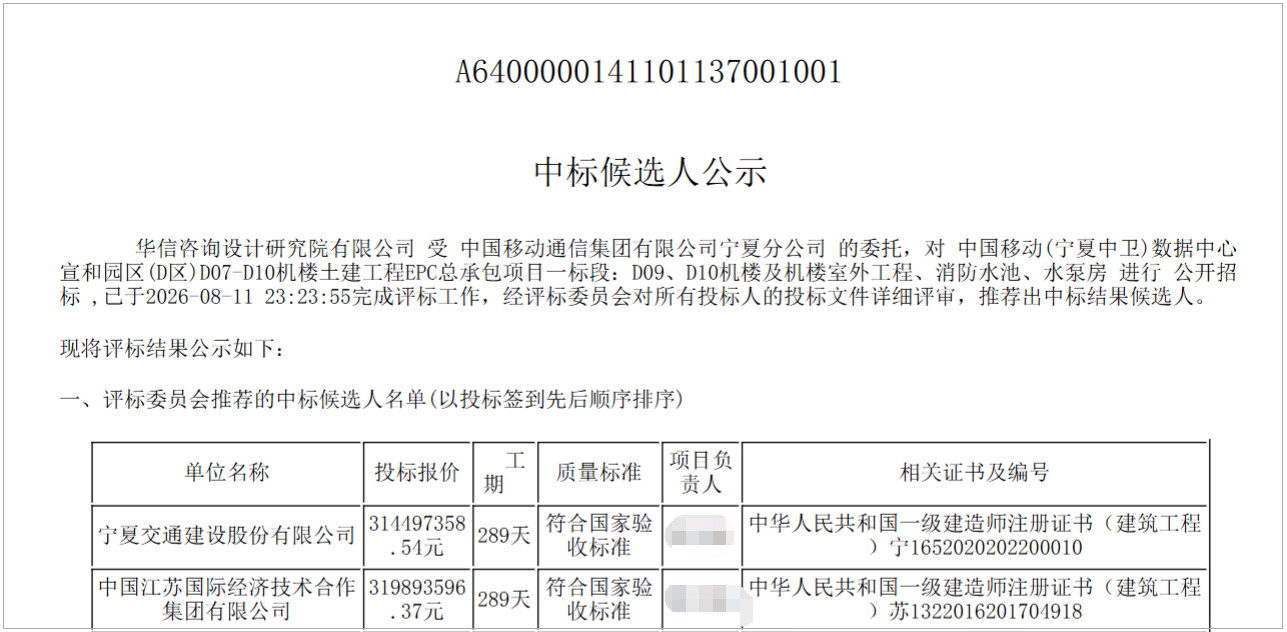

315 million project evaluation concludes
The project is led by China Mobile Communications Group Co., Ltd. Ningxia Branch for bidding, and adopts the EPC general contracting mode to integrate the entire process of design, procurement, and construction for integrated construction. The construction scope covers the main structure construction of the standardized computing machine buildings D09 and D10, outdoor supporting projects such as the park pipeline network and roads, as well as power support facilities such as fire water tanks and circulating water pump rooms. The project will complete all evaluation and review work on August 11, 2026. The evaluation committee will conduct a comprehensive evaluation from multiple dimensions, including enterprise qualifications, project performance, personnel configuration, bidding prices, and performance capabilities. Finally, three compliant and high-quality candidate enterprises will be selected and publicly announced in accordance with the law.

Three construction companies compete on the same stage
The three shortlisted candidate companies have fully responded to the requirements of the bidding documents, with a unified construction period of 289 days and a unified national acceptance standard. Ningxia Transportation Construction Co., Ltd. quoted the lowest price of 314.4974 million yuan. As a local state-owned enterprise, it has long been deeply involved in large-scale infrastructure construction in the northwest, familiar with the geological and wind sand climate construction difficulties in the Zhongwei Gobi Desert, and has natural advantages in ground material transportation and local coordination. Ningxia Xingqi Construction Co., Ltd. quoted 316.3225 million yuan, which is in the middle. It has long been rooted in the construction of Zhongwei Computing Power Park and is extremely familiar with special processes such as large-span data center rooms, load standards, and reserved water cooling facilities. China Jiangsu International Economic and Technological Cooperation Group Co., Ltd. has the highest quotation of 319.8936 million yuan, with qualifications for large-scale engineering general contracting at home and abroad, and a complete standardized construction and safety control system. However, the cost of construction in different locations is relatively high. All three project leaders hold a first-class registered constructor certificate in construction engineering, fully meeting the construction requirements of large-scale EPC general contracting projects. Keywords: high-tech news and information, computing power, infrastructure

Computing power based building solid foundation
The construction of data centers not only requires the main computer room, but also supporting facilities such as fire water tanks and water pump rooms, which are the lifeline of safety. The water pump room ensures stable circulation of the water-cooled cooling system in the machine room, maintaining a constant temperature and humidity operating environment; The fire water pool provides a safety net for extreme emergencies. After years of rolling development, Zhongwei Xuanhe Park has formed a multi zone linkage construction pattern of A, B, C, and D. Zone A is mature in operation, zone B continues to deliver, and zone D has become the core area for expanding computing power. After the completion of the D09 and D10 machine buildings, a large number of standard computing power cabinet resources will be added, continuing to undertake the landing of cloud computing, big data, and offline computing power businesses in the east, further amplifying the cost advantage of Zhongwei Green Power and Low Temperature Computing. If there are no valid objections after the public notice period ends, the project will officially enter the construction site. The 289 day construction period will force the project to proceed efficiently, providing sufficient time for subsequent mechanical and electrical installation, cabinet installation, and commercial use of computing power.Editor/Gao Xue
